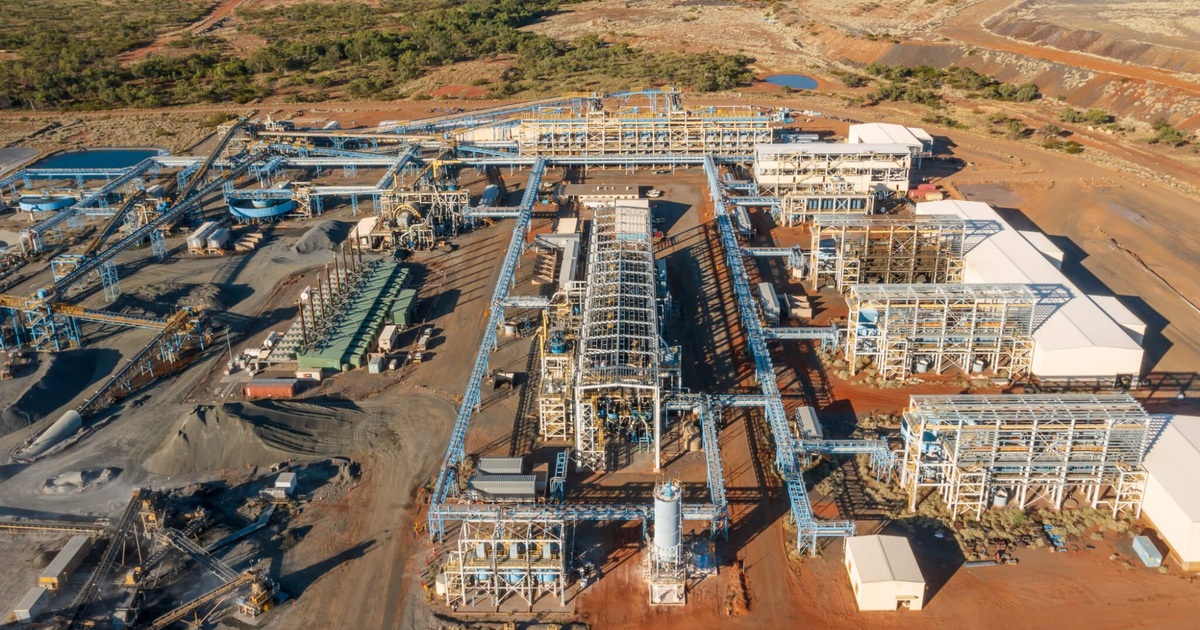

Austral Secures $15m QIC Investment to Advance Rocklands Expansion

Konrad Forrest
austral

7 August 2026 | Queensland - Austral Resources has secured a $15 million investment from the QIC Queensland Critical Minerals Fund to support expansion planning at its Rocklands copper processing facility in North West Queensland.

The funding has been structured as a non-dilutive royalty financing arrangement and will initially support a Stage 2 expansion scoping study, together with investigations into alternative power options for the operation.

The study will assess increasing Rocklands’ processing capacity from its existing 3.0 million tonnes per annum to between 4.5Mtpa and 6.0Mtpa.

Austral said the upper end of the proposed expansion range may be provisioned to provide additional capacity and future operating flexibility.

Existing plant capacity committed through 2034

Recent mine planning and optimisation work indicates Rocklands’ existing 3.0Mtpa processing capacity is expected to be fully utilised by Austral’s own sulphide ore production through to at least 2034.

The planned feed would come from Austral’s Western and Eastern operations, including resources that have been re-optimised in response to the stronger copper price environment.

Austral Chief Operating Officer Shane O’Connell said the expected utilisation of the existing plant provided a strong foundation for evaluating the next stage of expansion.

The Stage 2 study will examine how higher processing capacity and alternative power arrangements could improve operating efficiency and support the long-term competitiveness of Rocklands.

Why it matters

Austral is currently working toward restarting Rocklands, with engineering and procurement activities continuing ahead of first production, which remains targeted for the September quarter of 2027.

The new investment allows Austral to consider growth beyond the initial restart while continuing work to return the existing facility to production.

Austral’s longer-term strategy is to establish Rocklands as a regional copper processing hub for the Cloncurry and broader North West Queensland copper district.

An expanded facility could provide additional capacity for Austral’s future production and potentially support third-party ore through toll-treatment arrangements.

QCMF Fund Manager Joshua Risson said Rocklands had the potential to become important regional infrastructure by providing processing capacity that could help unlock stranded copper resources across North West Queensland.

Austral Chairman David Newling said the investment represented an endorsement of the Rocklands facility and the company’s long-term strategy.

He said Austral’s immediate priority remained the successful restart of Rocklands, but the QCMF backing would allow the company to begin planning the operation’s next phase of growth.

Royalty financing terms

Under the financing arrangement, Austral will pay QCMF a royalty on gross revenue generated through the Rocklands facility.

The royalty will be:

  • 0.80% of gross revenue for the first 200,000 tonnes of contained copper produced through Rocklands;
  • 0.30% of gross revenue for the subsequent 200,000 tonnes of contained copper; and
  • Nil after the second 200,000-tonne threshold is reached.

The royalty applies to copper produced from both Austral’s own material and any externally sourced feed processed through Rocklands.

Austral is required to establish commercial-scale production, defined as a run rate equivalent to 20,000 tonnes of contained copper, and make its first royalty payment before 31 December 2028.

For Queensland’s copper sector, the investment supports the return of a significant existing processing facility while opening a pathway toward greater regional processing capacity.

With the initial 3.0Mtpa plant expected to be committed to Austral’s own production for several years, the proposed expansion could strengthen Rocklands’ role as a major processing asset in one of Australia’s most important copper regions.

Source: Austral Resources Australia ASX announcement, “QIC Invests $15 Million to Advance Rocklands Growth Initiatives; Production Full Until 2034”, 7 August 2026.
